How to quickly identify Behind Schedule and Over Budget activity by Indicator UDF in Primavera P6

In Primavera P6, we can quickly identify behind schedule and over budget activity by using graphical indicator in User Defined Field.

I will show you how to do it.

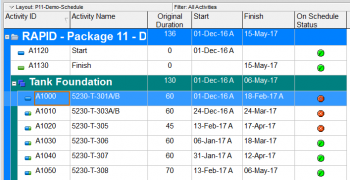

Supposed that we have a project which has baseline. After update progress, we can show these column the see whether an activity is behind schedule:
